Snowbird: Grand Opening of the Peruvian chair and Tunnel
Peruvian Express Details
By fall of 2006, Snowbird’s original Peruvian lift will be taken out and replaced with a new high-speed quad. While the base will stay near the original base shack, the top station will be located below the steepest Chip’s Run pitch, an approximately 2,408-vertical-foot rise. This 8,000- linear-foot lift transports 1,800 people per hour, providing an eight-minute ride. Should wind conditions prevent Tram operation, this lift will allow for continued skier access to Peruvian Gulch and Mineral Basin. At the top of the lift, a 600-foot tunnel with a conveyor lift will provide access to Mineral Basin. This lift makes Snowbird’s intermediate terrain more accessible to skiers and snowboarders.
CHAIRLIFT FACTS
Peruvian Tunnel Details
The first of its kind in North America, Snowbird’s new nearly 600-foot tunnel houses a conveyor lift that will transport skiers and riders from Peruvian Gulch into Mineral Basin. Located at the top of the new Peruvian Express high-speed quad, the 12-foot high, 10-foot wide tunnel provides a four-minute ride to intermediate terrain in Mineral Basin. The new tunnel and lift makes intermediate terrain more accessible to skiers and riders by eliminating many switchbacks and the steepest pitch of Chip’s Run. It also provides an efficient way to reach Hidden Peak without the use of the Tram.
TUNNEL FACTS
Why do it this way?
Many people have asked why Snowbird chose to construct a chair and tunnel rather than a chair that reached the top of the ridge. Here are the answers.



Hung
and ready to test!
11/17/2006

Hanging
chairs at the base
11/13/2006

Top
terminal and Tunnel entrance
11/10/2006

New
snow on the new chair
11/10/2006

Tunnel
floor and conveyor
11/03/2006

Inside
the Bottom Terminal
10/30/2006

Tower
One with Haul Rope installed
10/30/2006

Getting
ready for the cable
10/12/2006

Tunnel
doors installed
10/12/2006

Top
Terminal complete
10/12/2006

Finished
Tunnel floor
10/12/2006

New
Tunnel entrance
10/03/2006

Inside
the Tunnel
10/03/2006

Tower
installation
09/11/2006

35,000
lb main drives & gearbox
09/01/2006

Base
area grading
05/30/2006 VS 07/31/2006

86,000-pound
cable delivery
07/25/2006

Some
exterior skin goes on
07/19/2006

The
2nd story goes up
07/12/2006

Bottom
terminal progress
07/05/2006

New
at the base
06/27/2006

From
the Red Tram
06/08/2006

Lowering
the base
05/30/2006

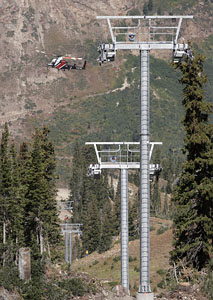

New
lift towers
05/17/2006

Goodbye
old chair
04/24/2006

Inside
the Tunnel
01/26/2006

Top
of the lift
09/21/2005

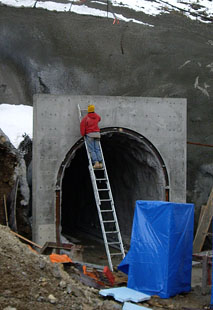

Tunnel
entrance
09/21/2005
